Minnesota Department of Transportation

511 Travel Info

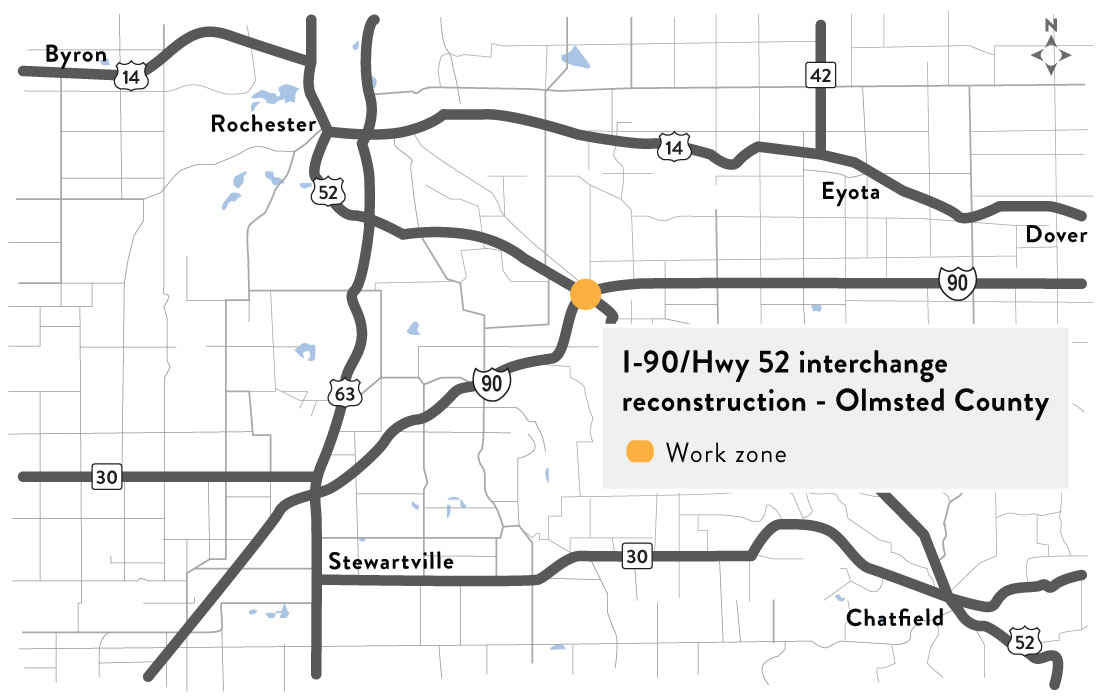

I-90/Hwy 52 interchange reconstruction

Olmsted County

Sign up for project email updates

Traffic impacts

Check www.511mn.org or the free mobile app to see current traffic impacts. The below dates are subject to change.

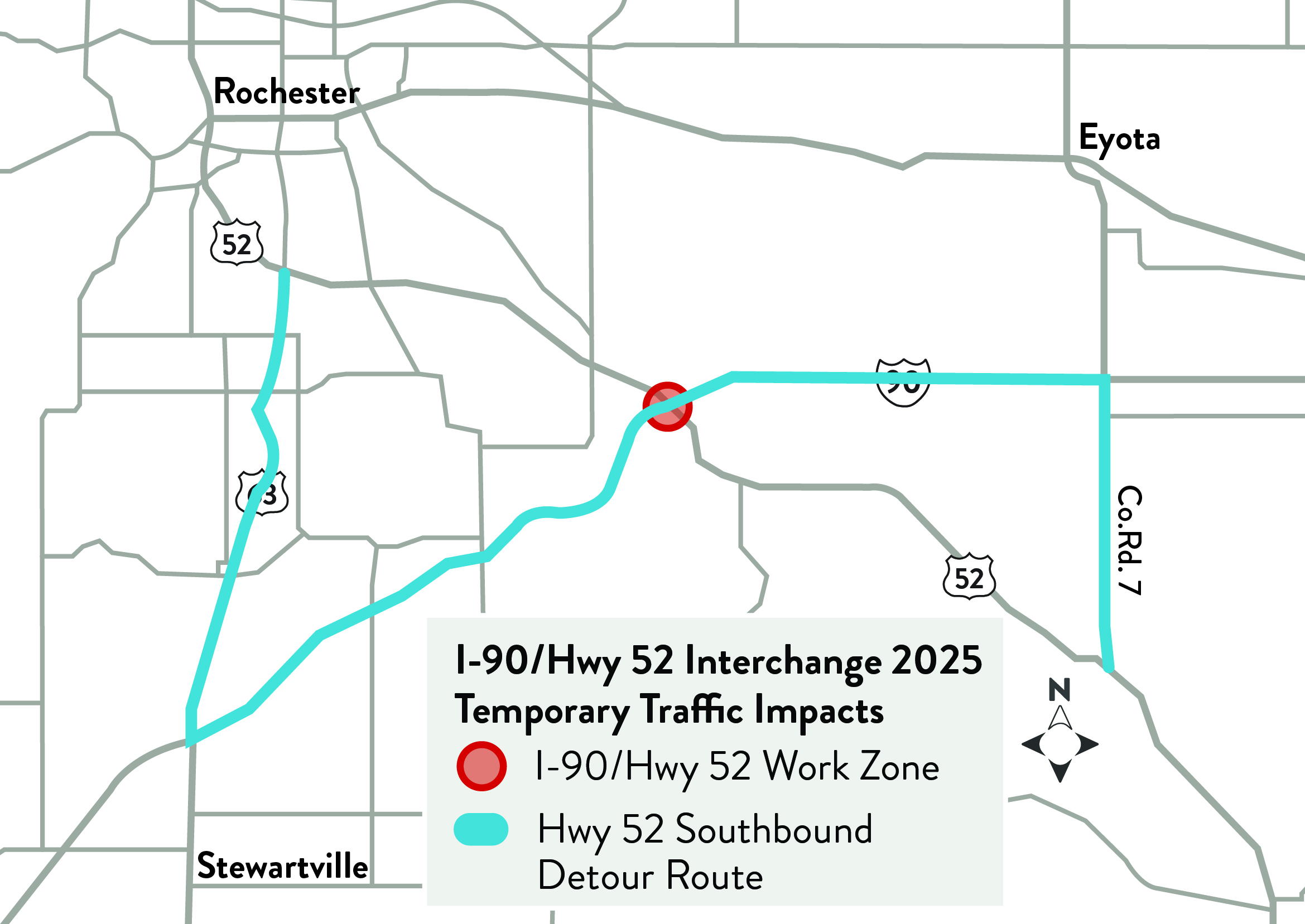

Southbound Hwy 52 closed, detoured July 15, 6 a.m.-9 p.m., to set bridge beams

  • Southbound Hwy 52 motorists will be detoured in Rochester to Hwy 63 south to I-90 east at Stewartville

    • Traffic with destinations further south on Hwy 52 will exit eastbound I-90 at Exit 224 (Eyota exit), travel south on Olmsted Co. Rd. 7 to Hwy 52 north of Chatfield - detour map
  • Northbound Hwy 52 will remain open, and motorists are able to exit westbound I-90 to go north on Hwy 52 andI-90 remains open in both directions

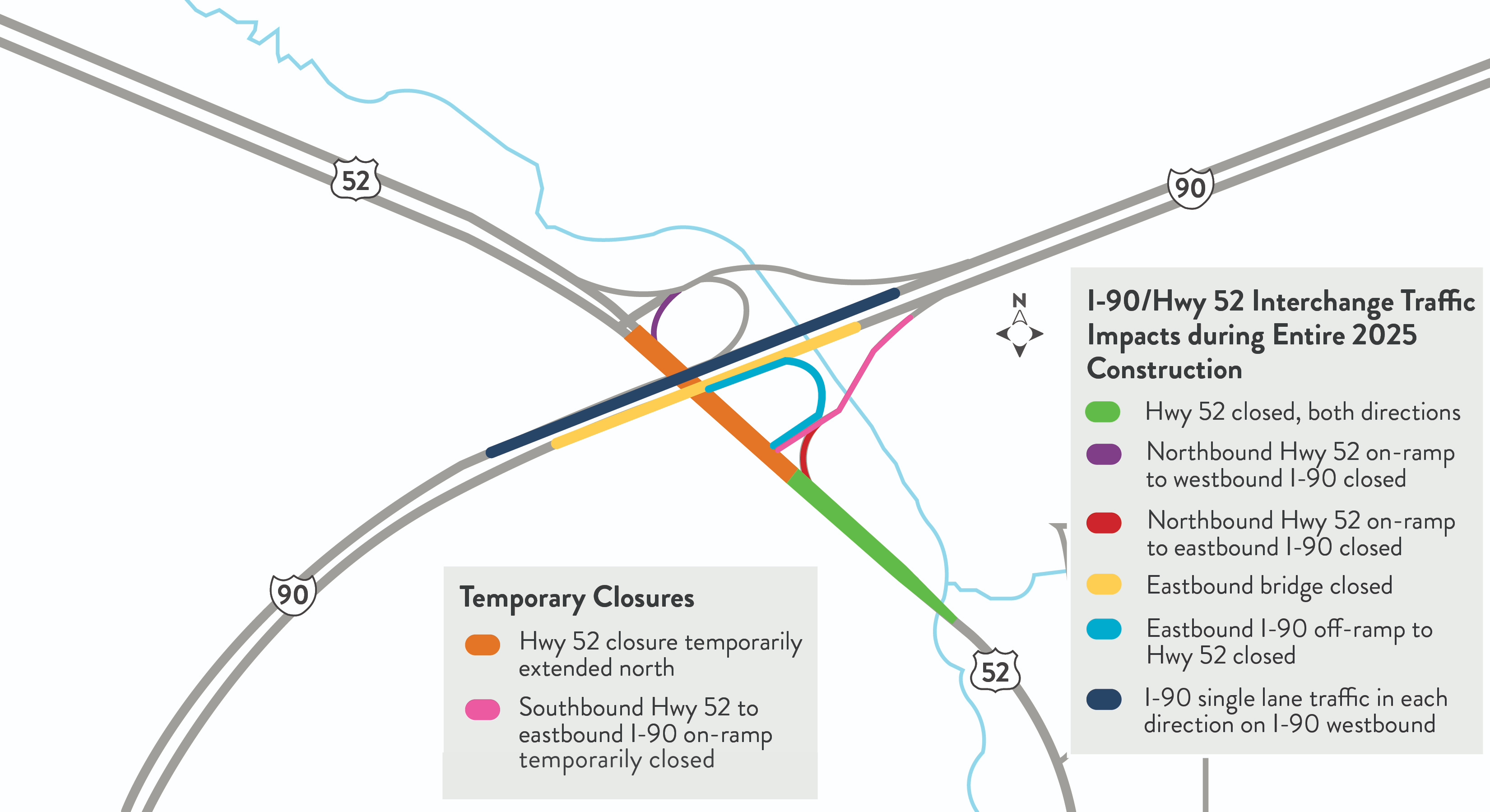

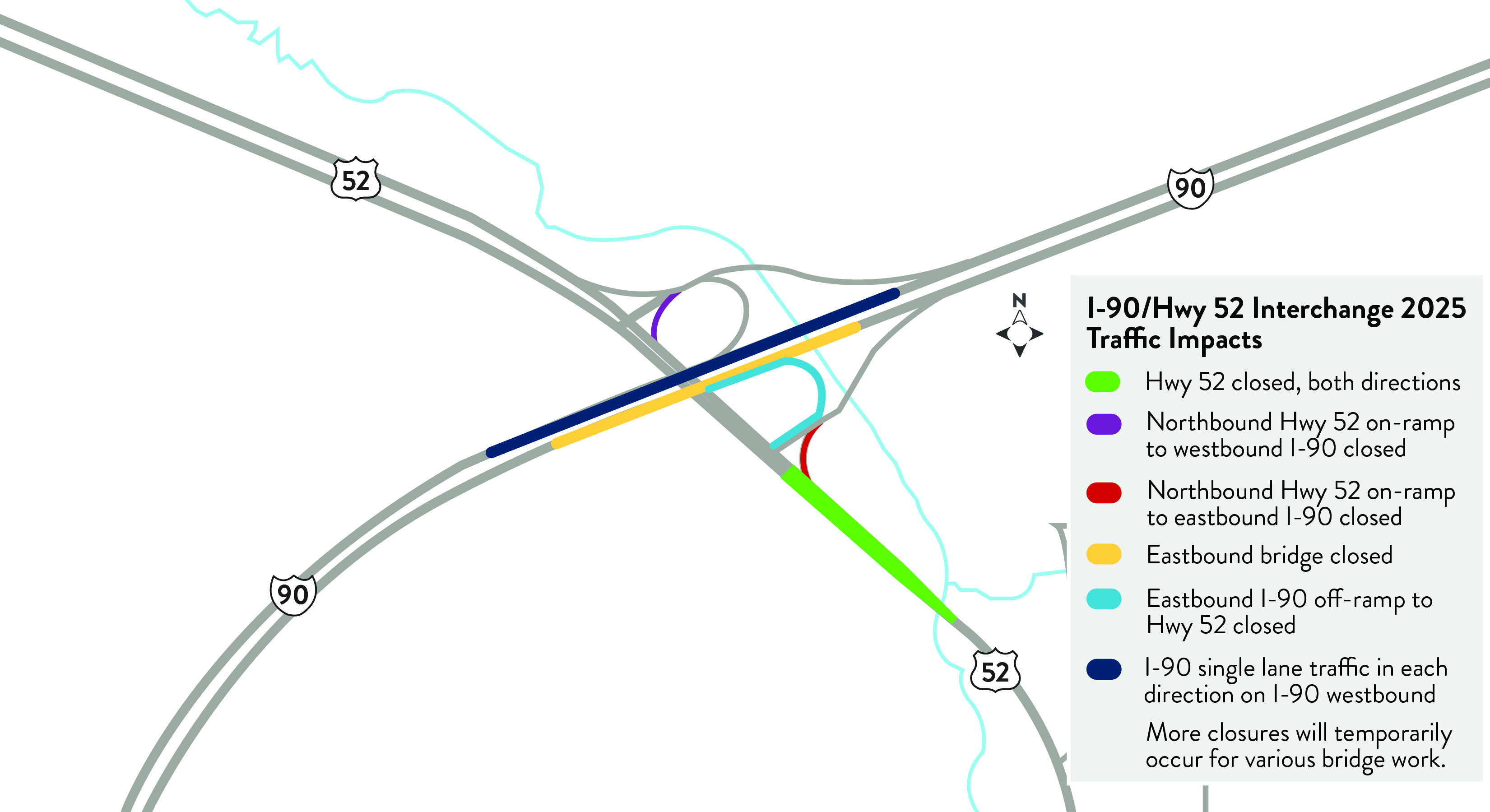

Closures during entire 2025 construction

I-90/Hwy 52 interchange project map
Closures during entire 2025 construction - click on image to view larger map
  • I-90 westbound and eastbound traffic will travel in single lanes adjacent to each other on I-90 westbound in the project area (scheduled April 4 to November) while the new I-90 eastbound bridge is being constructed
  • Eastbound I-90 off-ramp to Hwy 52 closed (scheduled April 4 to November)
    • Continue on eastbound I-90 and take Exit 224 (Eyota exit) - detour map
      • To go south on Hwy 52, go south on Olmsted Co. Rd. 7 which intersects with Hwy 52
      • To go north on Hwy 52, turn left over bridge and exit onto westbound I-90, take ramp to Hwy 52 (Exit 218)
  • Hwy 52 closed, south of eastbound I-90 on-ramp (scheduled April 8 to November) - detour map
    • To travel north on Hwy 52 (from Chatfield), go north on Olmsted Co. Rd. 7 and exit onto westbound I-90, take ramp to Hwy 52 (Exit 218)
    • To travel south on Hwy 52 (from Rochester), exit to I-90 eastbound, take Exit 224 (Eyota exit), take a right and go south on Olmsted Co. Rd. 7 which intersects with Hwy 52
  • Northbound Hwy 52 on-ramp to eastbound I-90 closed (scheduled April 8 to November)
    • Go north on Olmsted Co. Rd. 7 and exit onto eastbound I-90 - detour map
  • Northbound Hwy 52 on-ramp to westbound I-90 closed (scheduled April 8 to November)
    • Go north on Olmsted Co. Rd. 7 and exit onto westbound I-90 - detour map

Open during 2025 construction

  • Westbound I-90 off-ramp to northbound Hwy 52
  • Southbound Hwy 52 on-ramp to westbound I-90
  • Southbound Hwy 52 on-ramp to eastbound I-90 (with the exception of temporary closures)

About this project

Summary of work

I-90/Hwy 52 interchange project map
I-90/Hwy 52 interchange project map

Construction is scheduled 2024-2026 to make changes to the I-90/Hwy 52 interchange to improve safety and reduce delays.

  • 2024: Constructed temporary crossovers and begin new ramps and loops
  • 2025 (April to November): Construct new eastbound I-90 bridge, flyover bridge over Hwy 52 and portion of new ramps and loop
  • 2026: Construct new westbound I-90 bridge and remaining portion of new ramps and loops

Improvements

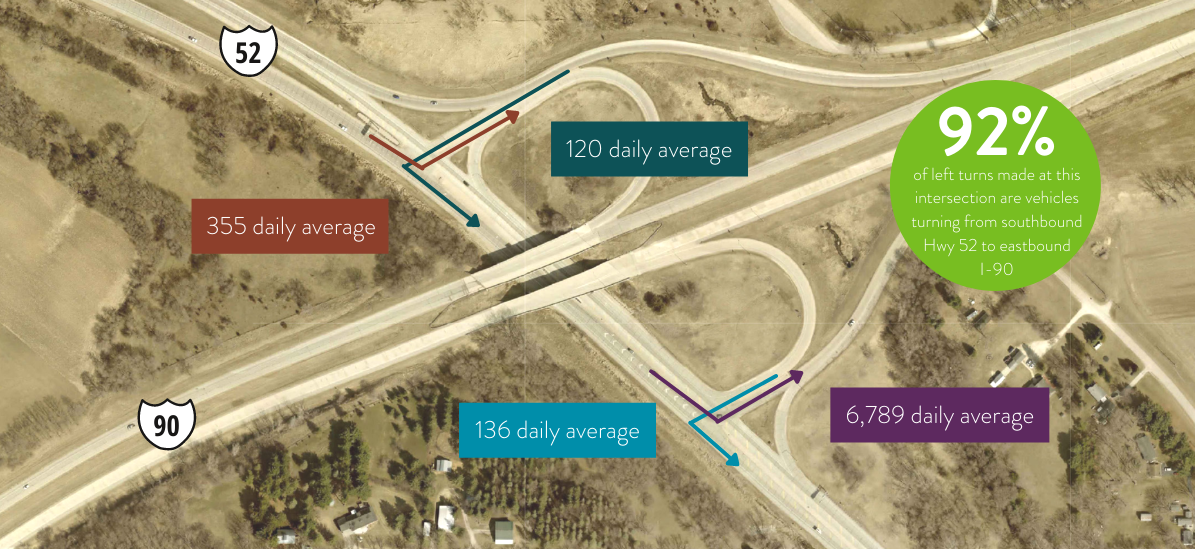

A new feature, a flyover ramp, for southbound Hwy 52 to eastbound I-90, will solve several problems:

New ramps will reduce the run-off-the-road crashes:

  • Changing the angles will allow for better, more controlled entrance/exit
  • Lengthened accelerations lanes will also improve conditions

The bridge replacements will allow for:

  • Relocation of the bridge piers that block the view of on-coming traffic
  • Improved bridges that will last another 60 years or more

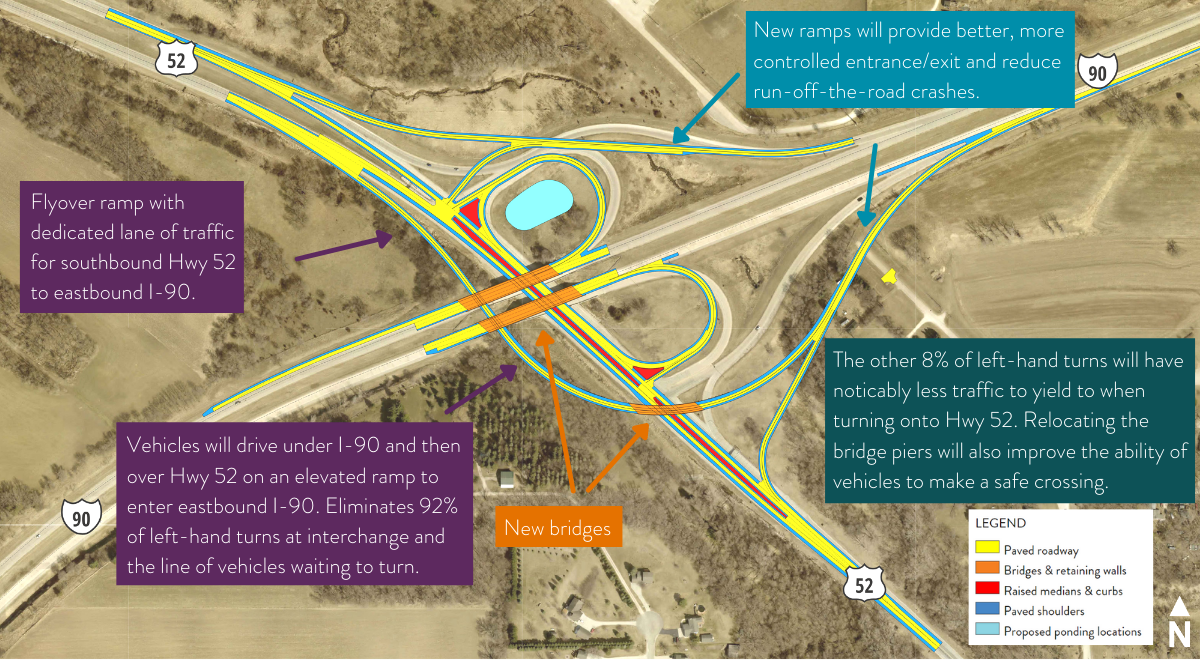

Proposed changes at interchange
Improvements at I-90 and Hwy 52 interchange
